Kansas City, MO · I-670, Wyandotte Street to Grand Boulevard

South Loop Link - Blunt Luminary Park

Tier 4 Funded (Partial) Adjacent to Downtown Council service area Mechanism: MoDOT grant + TIFIA loan (pending) + private + bonds (proposed)
people watching
Project Media
Developer flythrough of the South Loop Link concept.
Zone 1 - The RecordPlat Street · Cited · Not editable by claimed accounts

A project to cap four blocks of Interstate 670 in downtown Kansas City - from Wyandotte Street to Grand Boulevard - turning the highway into a tunnel and building a roughly 5.5-acre park on top, connecting downtown to the Crossroads Arts District. Total project cost has been reported between $217M (2024) and $315M (2026) as the scope and cost estimate evolved; this is exactly the kind of figure drift Scope is built to show rather than silently update.

Funding Stack

SourceAmountMechanismStatus
Missouri DOT cost-share grantKansas City Star, Dec. 2024 - awarded to help repair aging I-670 infrastructure alongside the cap $31.4M State DOT cost-share program Awarded
Federal, state, local & private funds raised to dateKansas City Star reporting - "about $110M on hand" by Aug. 2024; "at least $141M raised" by Dec. 2024 $110M–$141M Mixed sources, ongoing fundraising Raised
TIFIA federal loanKansas City Star - city sought up to $65M via the U.S. DOT's Build America Bureau; City Council Ordinance No. 240602 authorized the application Up to $65M
⚠ Not confirmed closed
TIFIA credit assistance Pending / status unclear
Reconnecting Communities federal grantKansas City Star - $75M application "fell through" in March; separately, a $25M federal grant was missed as of the Aug. 2026 Kansas City Business Journal report $0
⚠ Applications unsuccessful
Federal discretionary grant (declined) Not awarded
City special obligation bondsKansas City Business Journal, Aug. 13, 2026 - City Council "may consider another tranche" to enable construction to start Amount TBD
⚠ Proposed, not yet approved
Municipal special obligation bonds Proposed

This is a project where the funding stack itself is the story: two federal grant applications have not succeeded, a federal loan's status is unconfirmed in the most recent reporting, and the city is now weighing bonds to bridge the remaining gap on a project whose total cost estimate has grown by roughly $100M since 2024.

Project Team

Approval & Funding Timeline

  • 2023 (approx.)Project announced at an estimated $217MKansas City Star
  • 2024 (spring)$75M federal "Reconnecting Communities" grant application unsuccessfulKansas City Star
  • 2024 (summer)City Council finance committee recommends pursuing up to $65M TIFIA federal loan (Ordinance No. 240602)Kansas City Legistar, File #240602
  • 2024-08~$110M raised to date across public and private sourcesKansas City Star
  • 2024-12MoDOT awards $31.4M cost-share grant; City Council approves pre-construction contracts with JE Dunn and Clarkson Construction; at least $141M raised to dateKansas City Star
  • 2026-08Reported as the $315M "Blunt Luminary Park"; missed a separate $25M federal grant; City Council may consider special obligation bonds to enable construction to beginKansas City Business Journal, Aug. 13, 2026

Litigation & Legal Filings

No litigation found in public reporting as of this preview.

Zone 2 - Official Notices & Public MeetingsPlat Street · Sourced to public reporting
Council Committee
Finance committee recommendation on TIFIA loan application (Ordinance No. 240602) · 2024 (summer)
Public Forums
Series of public forums on project design - the last of four planned forums did not occur as scheduled · reported as of Kansas City Star coverage
Environmental Review
Draft environmental assessment released, addressing bridge closure options (Baltimore Ave. or Walnut St.) · Kansas City Star coverage
Zone 3 - Claimed by the Project TeamNot Claimed · Feature Mockup

Developer Renderings

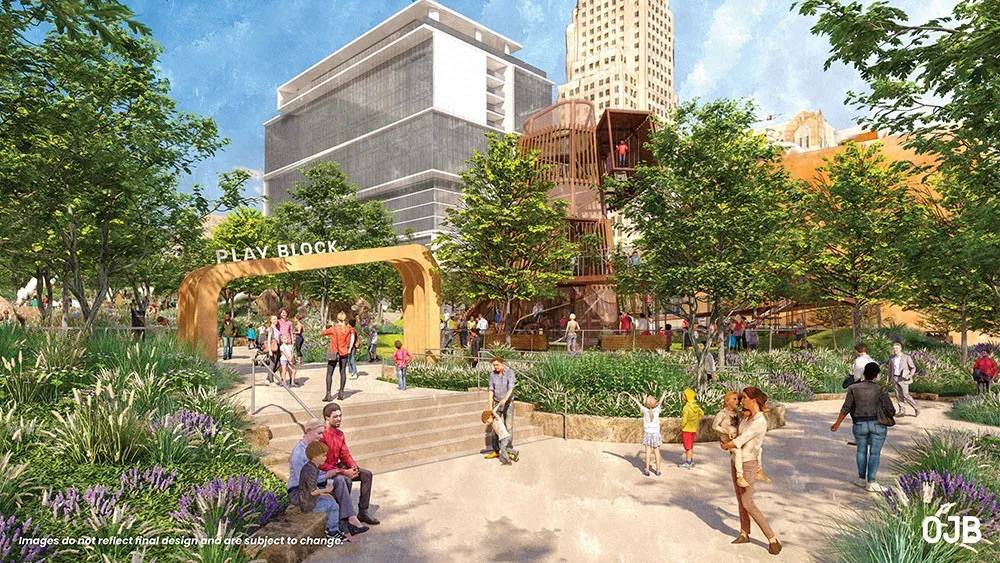

Luminary Park play block rendering Rendering
Luminary Park play block

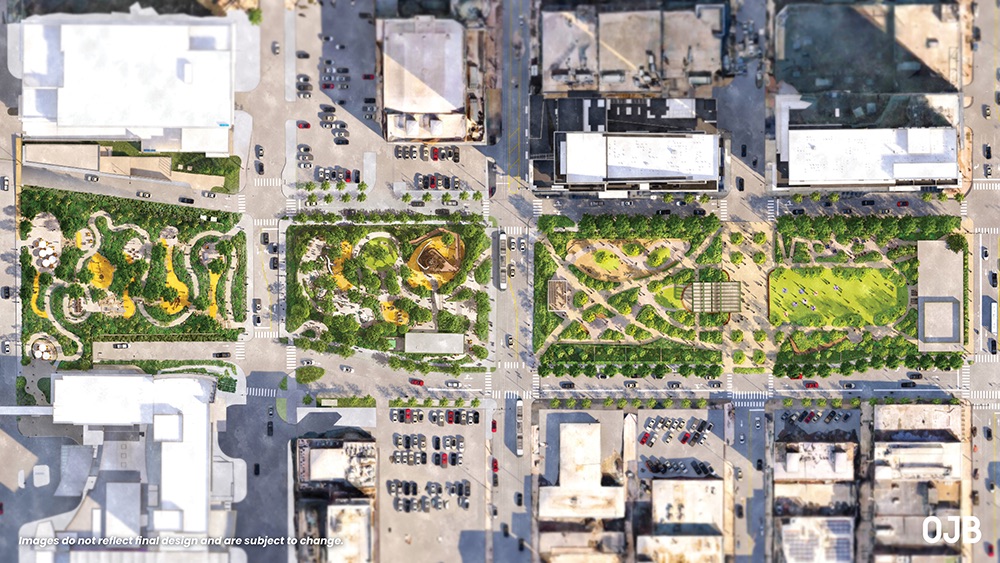

Aerial rendering of the four-block cap Rendering
Aerial view of the four-block cap

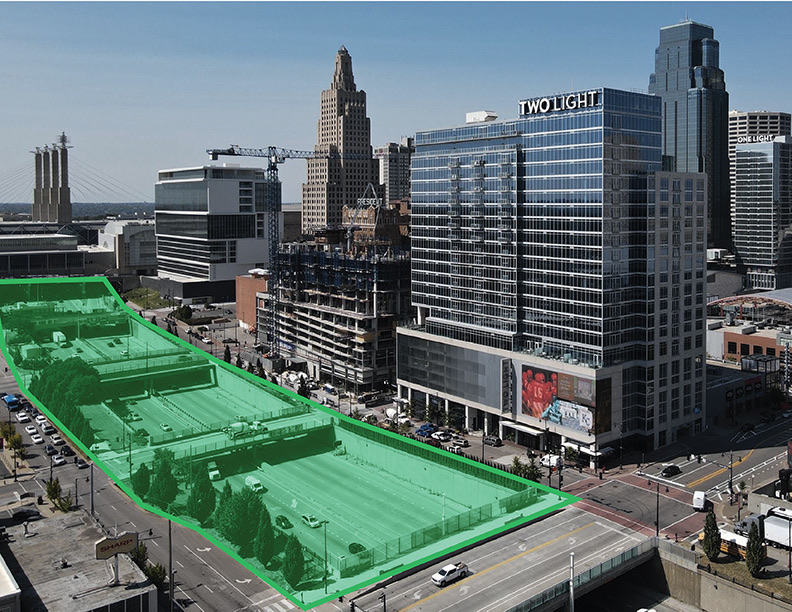

Study area site photo Site
Study area looking west from Two Light

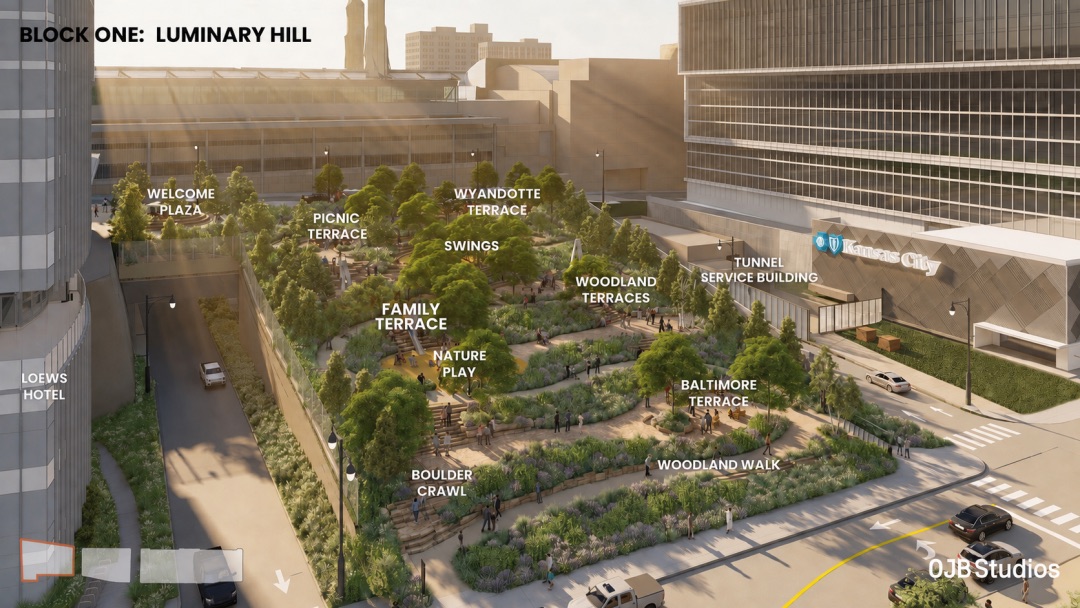

Block One Luminary Hill rendering Rendering
Block One: Luminary Hill

Documents Uploaded by the Project Team

  • FONSI - Appendix A (Final EA) Open
  • FONSI - Appendices B, C, D Open
This page has not been claimed. Neither the City of Kansas City nor the Downtown Council has an account on Scope - the statement below is a sample of what the feature would look like, not a real quote from either organization.
  • Sample statement · illustrative only

    If claimed, would be submitted by project team, not verified by Plat Street

    "We remain confident the South Loop will get built. The city is actively working through several financing paths to close the remaining gap and keep the project on track." - Illustrative only, not an actual statement from the City of Kansas City.

Trade Partners

Firms and professionals whose work is not named on a public record but have provided other proof of involvement. Each has a directory page.

Zone 4 - From the CommunityIllustrative comments
This is open comment, not an official record - illustrative for this preview.
DT
D. Torrenceillustrative
Would like to see an actual funding timeline before another round of renderings. The gap has been growing, not shrinking.
GeometryHighway cap segment, approximate
Approximate cap segment: I-670 from Wyandotte Street to Grand Boulevard, downtown Kansas City.
